SQMTrove user guide · Chapter 11

11. Monitoring: plan, activities and inspections

Steps in this chapter (7)

7 steps, each with a screenshot · Chapter 11 of 22

Approve the monitoring plan, schedule inspections and tests of responses, follow the engagement partner inspection cycle, and inspect engagement files with SQMTrove's checklist.

ISQM 1.35–39 require monitoring activities that give relevant, reliable and timely information about the system, including inspection of completed engagements for each engagement partner on a cyclical basis. The monitoring and remediation lead — at Okafor Bello & Co, Kunle Adebayo, Director of Quality Assurance — plans and performs them, and must be objective: nobody inspects an engagement they worked on.

On 2 February 2026 Kunle records the 2026 plan and its activities. In May he inspects three 2025 audits: Ikeja Polymers (good), Savannah Harvest (limited improvements) and Amberfield Pensions (improvements required).

11.1 Approve the monitoring plan

SQMTrove screenshot: Monitoring & remediation → Plan, 2 February 2026. Numbered orange markers point to the items described in the steps.

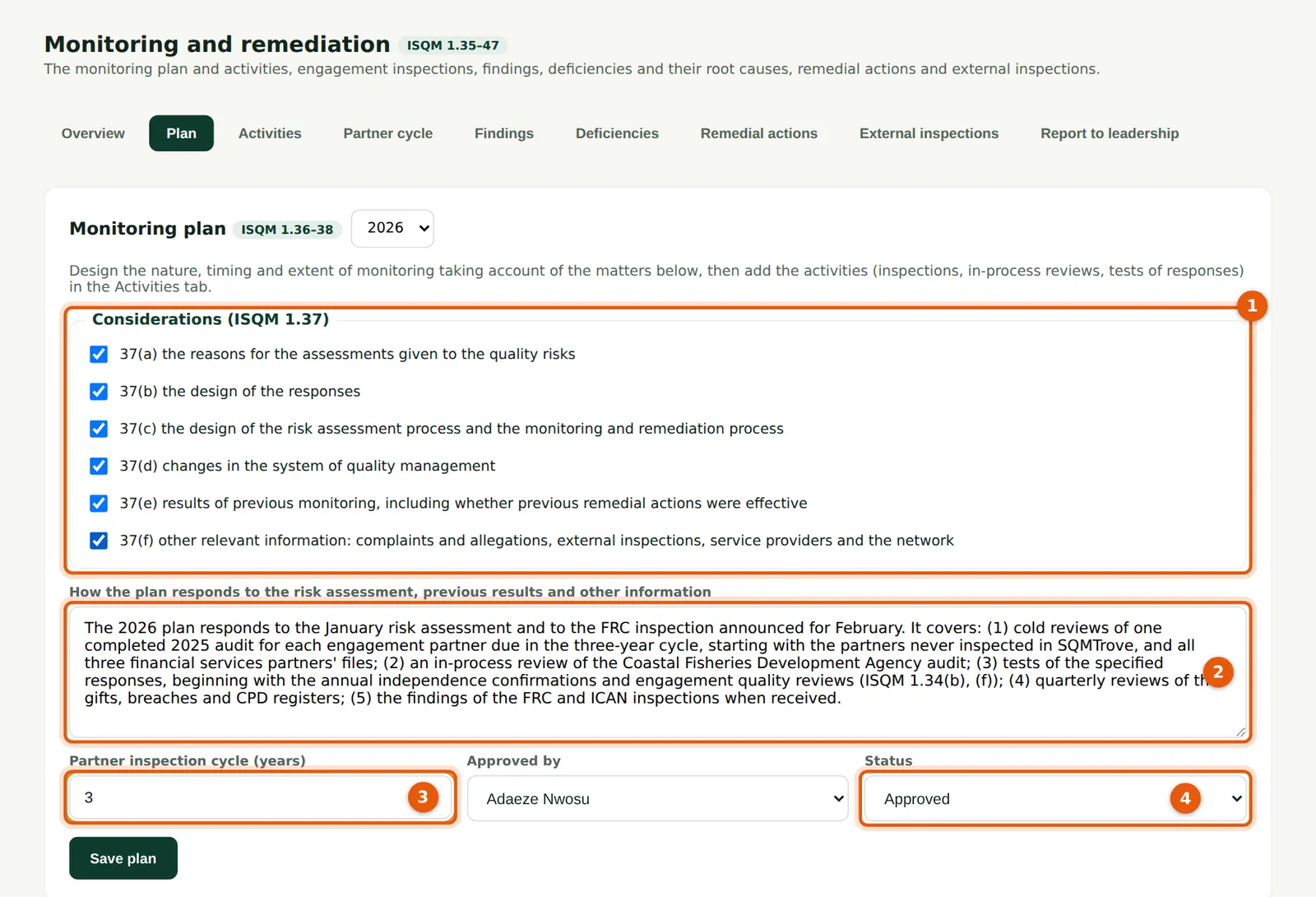

Figure 11.1 — Monitoring & remediation → Plan, 2 February 2026

Why

ISQM 1.37 lists what the plan must consider (1): the reasons for the risk assessment, the design of monitoring, changes in the system, previous monitoring, external inspections and other information. The rationale (2) explains how the plan responds. The partner inspection cycle (3) is set here. A plan can be approved (4) only when every matter is considered and the approver is recorded.

Who

Monitoring lead; approved by the Owner or quality lead.

What to do

  1. Tick each matter considered (1) and write the rationale (2).
  2. Set the cycle (3), choose who approved it and the status Approved (4); choose Save plan.

Back to top ↑

11.2 Add a monitoring activity

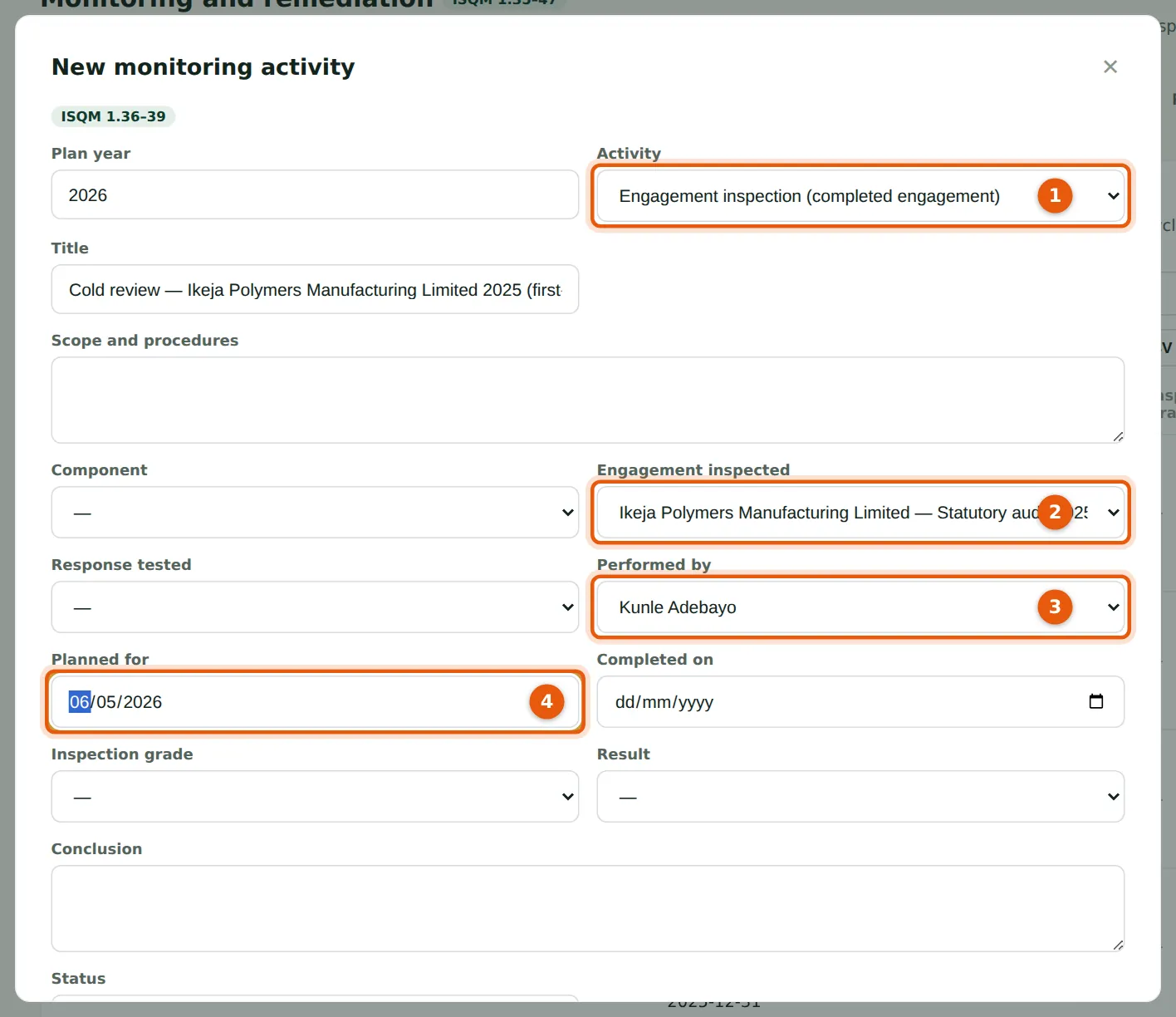

SQMTrove screenshot: Activities → New activity: cold review of Ikeja Polymers 2025. Numbered orange markers point to the items described in the steps.
Figure 11.2 — Activities → New activity: cold review of Ikeja Polymers 2025

Why

Activities include inspections of completed engagements, in-process reviews, tests of responses, walk-throughs and ongoing reviews of registers (1). An inspection names the engagement (2) and inspector (3); SQMTrove refuses an inspector who was on the engagement team. The planned date (4) puts the activity on the inspector's dashboard.

Who

Monitoring lead.

What to do

  1. Choose New monitoring activity; choose the type (1), engagement (2), inspector (3) and planned date (4); choose Add.

Back to top ↑

11.3 The activities of the year

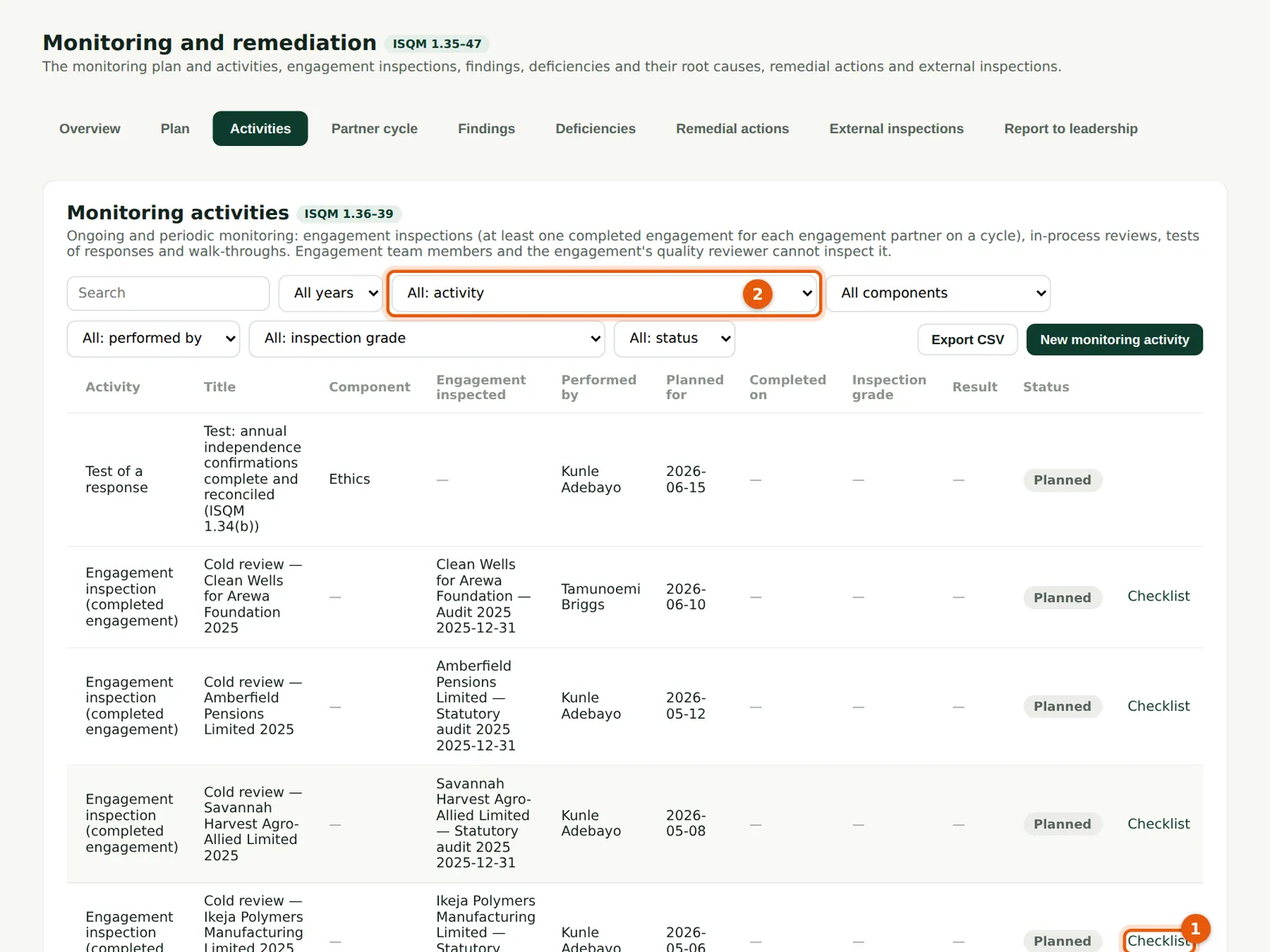

SQMTrove screenshot: Activities, 2026 plan. Numbered orange markers point to the items described in the steps.
Figure 11.3 — Activities, 2026 plan

Why

Each activity with its type (filter 2), inspector, dates, status and result. Inspections and in-process reviews have a Checklist link (1). A planned activity past its date shows as late on the dashboard and in the evaluation evidence.

Who

Monitoring lead; inspectors.

What to do

  1. Choose Checklist (1) to perform an inspection.

Back to top ↑

11.4 The partner inspection cycle

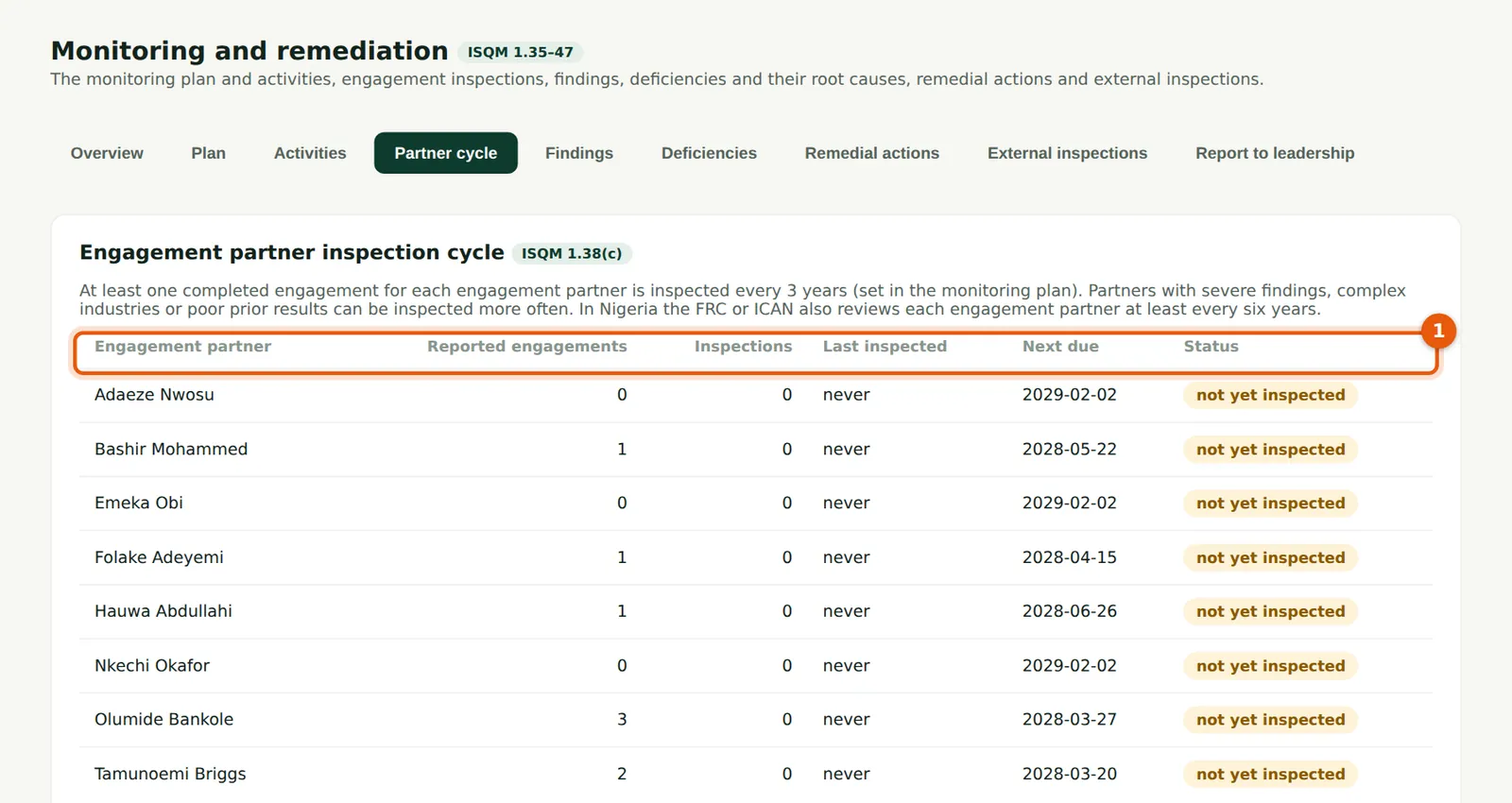

SQMTrove screenshot: Partner cycle: when each engagement partner is next due. Numbered orange markers point to the items described in the steps.
Figure 11.4 — Partner cycle: when each engagement partner is next due

Why

For each engagement partner (1): reported engagements, inspections, the last inspection and the next due date under the cycle. A partner never inspected shows as not yet inspected until the date passes, then overdue. In Nigeria the FRC or ICAN also reviews each engagement partner.

Who

Monitoring lead.

What to do

  1. Plan an inspection for every partner due within the year.

Back to top ↑

11.5 Inspect an engagement file

SQMTrove screenshot: Inspection of Amberfield Pensions Limited 2025, 12 May 2026. Numbered orange markers point to the items described in the steps.
Figure 11.5 — Inspection of Amberfield Pensions Limited 2025, 12 May 2026

Why

The checklist covers acceptance and ethics, planning and risk assessment, execution (including accounting estimates, going concern and journals), review, consultation and the engagement quality review, the report and file assembly, with ISA references. Answer Yes, No or N/A for each (1) with a note of the evidence (2). Each No becomes a finding when you raise findings.

Who

The inspector.

What to do

  1. Answer each question (1) and note the evidence (2).
  2. Choose Save as you go; choose Save and raise findings when done.

Back to top ↑

11.6 Grade and complete the inspection

SQMTrove screenshot: Findings raised; grade and conclusion. Numbered orange markers point to the items described in the steps.

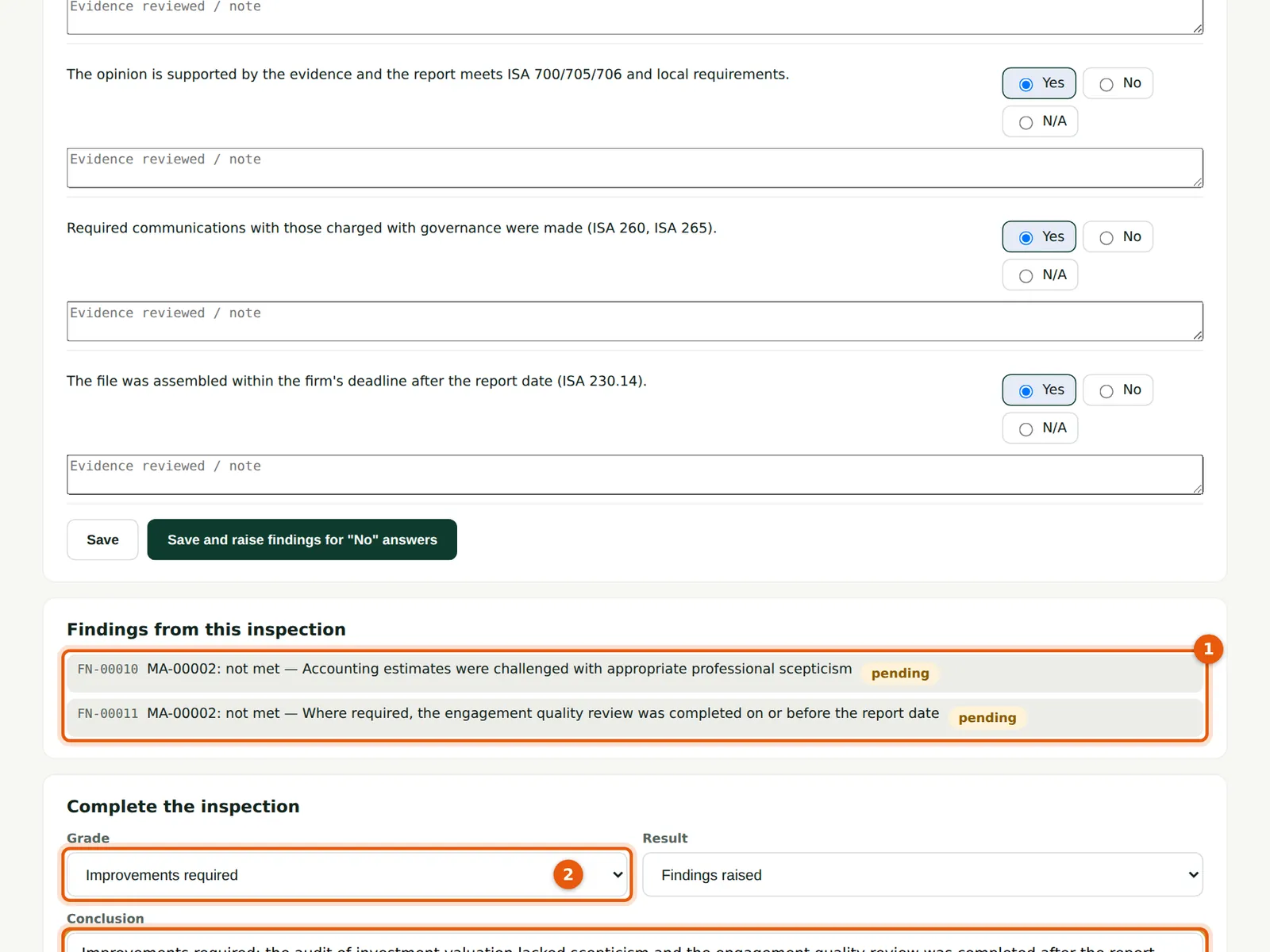

Figure 11.6 — Findings raised; grade and conclusion

Why

The findings raised (1) are listed with the question they come from. Grade the file (2) — good, limited improvements, improvements required or significant improvements required — and write the conclusion (3) that goes to the engagement partner. Completing (4) records the date for the partner cycle.

Who

The inspector.

What to do

  1. Choose the grade (2), write the conclusion (3) and choose Complete the inspection (4).

Back to top ↑

11.7 The monitoring overview

SQMTrove screenshot: Monitoring & remediation → Overview, May 2026. Numbered orange markers point to the items described in the steps.

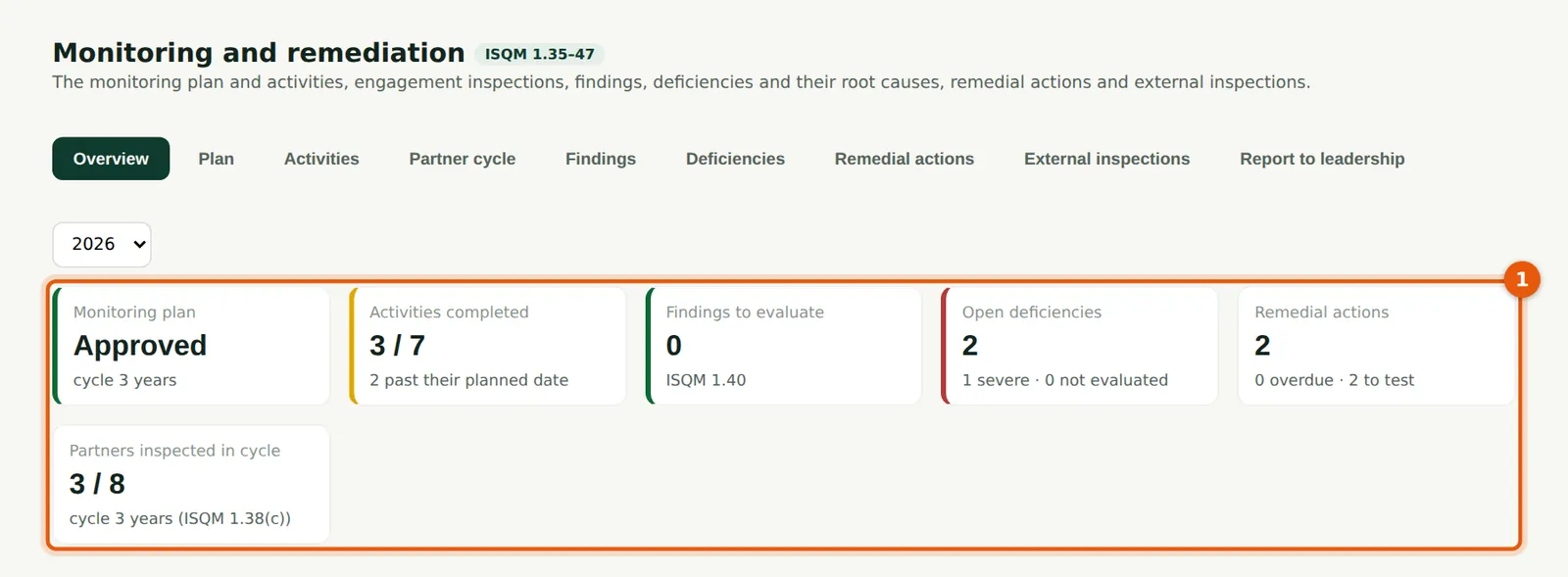

Figure 11.7 — Monitoring & remediation → Overview, May 2026

Why

The plan, activities completed and late, findings to evaluate, open and severe deficiencies, remedial actions overdue or waiting to be tested, and partners due for inspection (1).

Who

Monitoring lead; leadership.

What to do

  1. Choose a tile to open the list behind it.

Back to top ↑
