SQMTrove user guide · Chapter 15

15. The annual evaluation of the system

Steps in this chapter (10)

10 steps, each with a screenshot · Chapter 15 of 22

Prepare the evaluation as at the evaluation date from frozen evidence, conclude on each component and overall under ISQM 1.54, and sign it as the individual with ultimate responsibility.

ISQM 1.53–55 require the individual with ultimate responsibility to evaluate the system at least once a year, as at a point in time, and to conclude whether it provides reasonable assurance that its objectives are achieved (54(a)), does so except for severe but not pervasive deficiencies (54(b)), or does not (54(c)). ISQM 1.55 requires prompt action and communication when the conclusion is 54(b) or 54(c).

Okafor Bello & Co's evaluation date is 30 June. Emeka Obi prepares the 2026 evaluation on 20 July; Adaeze Nwosu signs it on 14 August with conclusion 54(b), because DF-00001 is severe, not pervasive and still being remediated.

15.1 Start the evaluation

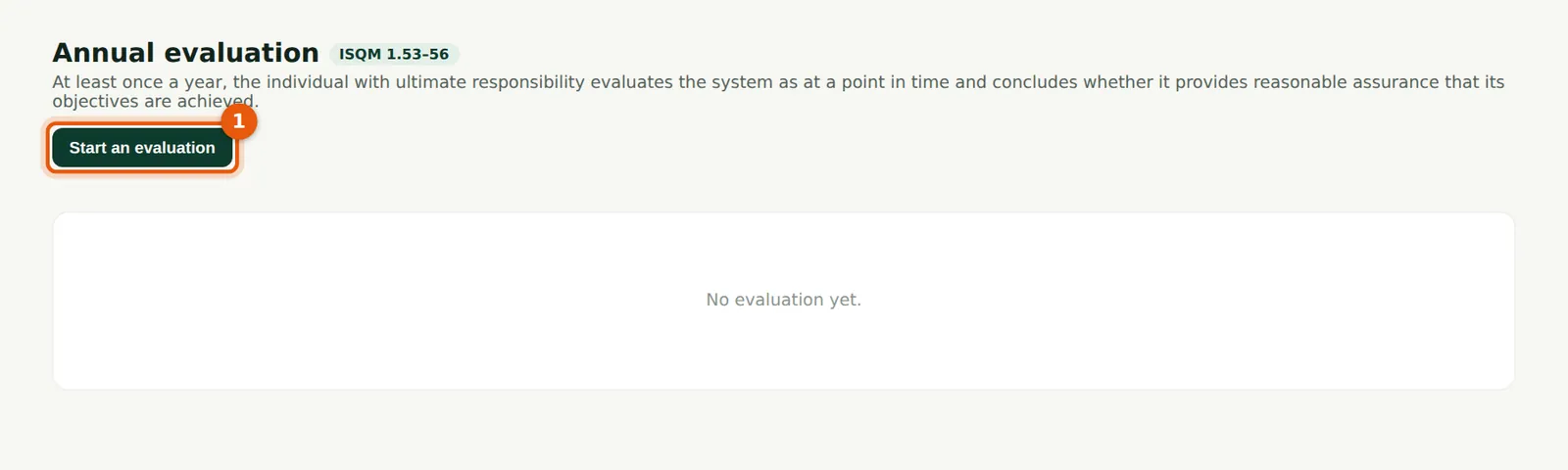

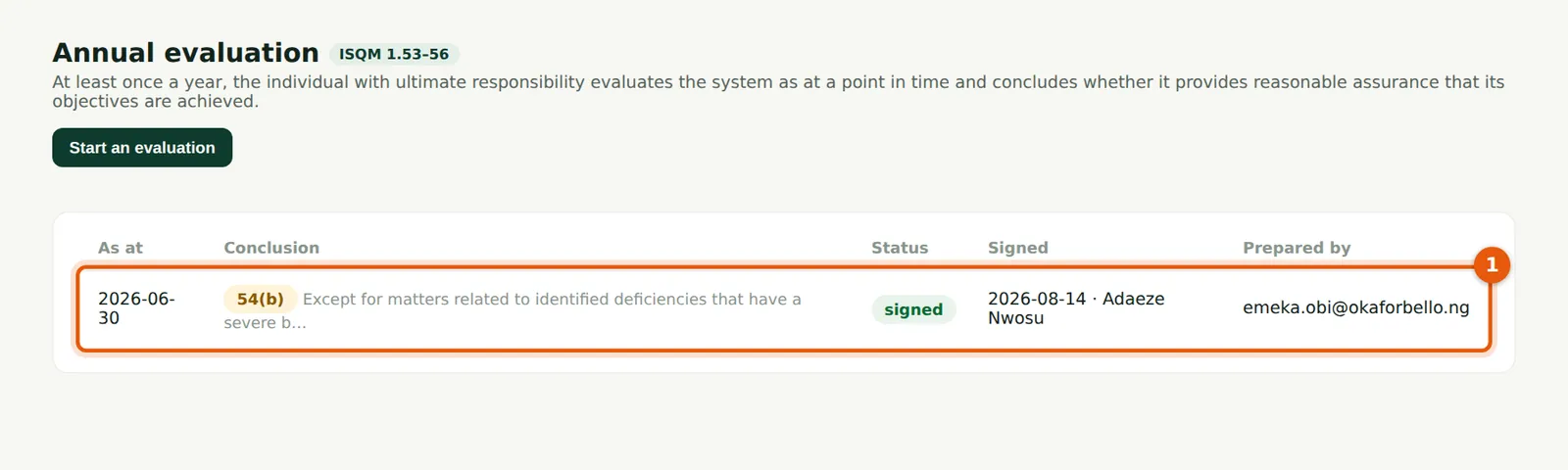

SQMTrove screenshot: Annual evaluation, 20 July 2026. Numbered orange markers point to the items described in the steps.
Figure 15.1 — Annual evaluation, 20 July 2026

Why

The page lists the firm's evaluations. Start one (1) after the evaluation date.

Who

Quality lead (prepares).

What to do

  1. Choose Start an evaluation (1).

Back to top ↑

15.2 Choose the evaluation date

SQMTrove screenshot: The evaluation date. Numbered orange markers point to the items described in the steps.
Figure 15.2 — The evaluation date

Why

The date (1) defaults to the firm's evaluation date (Settings). The evidence is gathered as at that date.

Who

Quality lead.

What to do

  1. Check the date (1) and choose Start.

Back to top ↑

15.3 The evidence

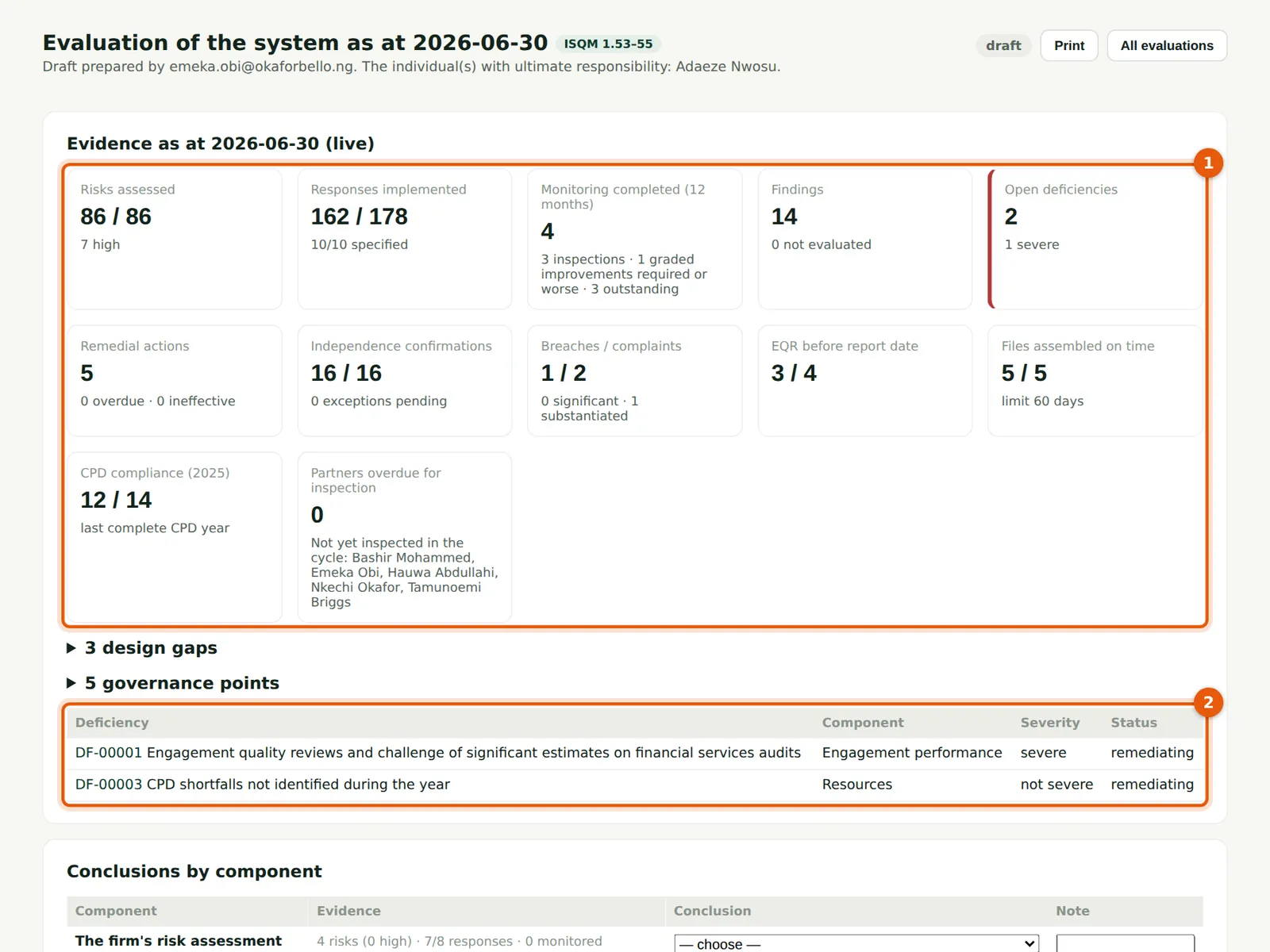

SQMTrove screenshot: Evidence as at 30 June 2026. Numbered orange markers point to the items described in the steps.
Figure 15.3 — Evidence as at 30 June 2026

Why

SQMTrove gathers the evidence (1): risks assessed, responses implemented, monitoring completed, findings, open deficiencies, remedial actions, independence confirmations, breaches and complaints, reviews before the report date, files assembled on time, CPD compliance for the last complete year and partners overdue for inspection. The component matrix (2) shows the evidence for each component; design gaps and governance points are listed below.

Who

Quality lead; the Owner reviews.

What to do

  1. Read each figure (1) and the matrix (2); open the design gaps and governance points.

Back to top ↑

15.4 Conclude on each component

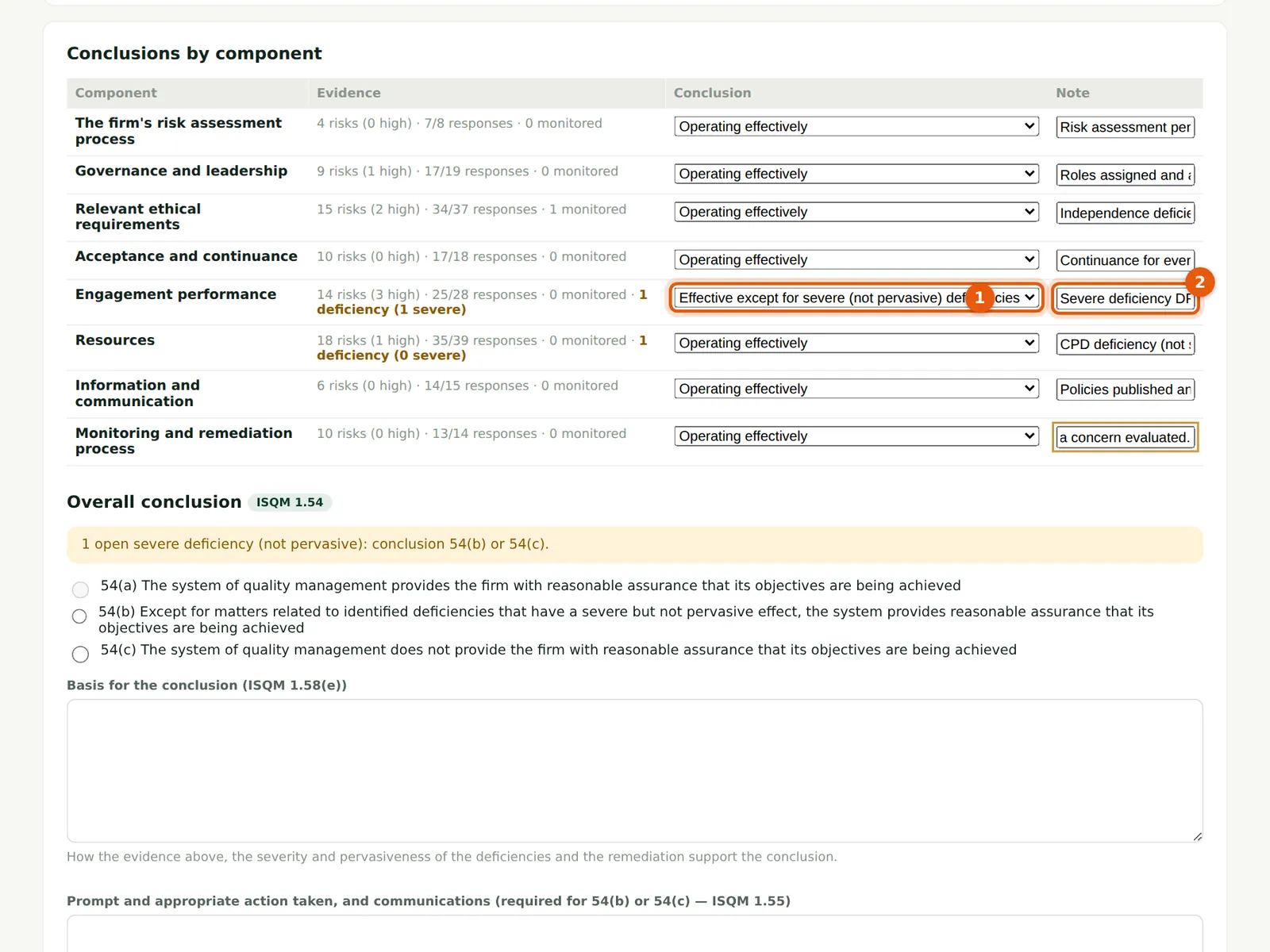

SQMTrove screenshot: Conclusions by component. Numbered orange markers point to the items described in the steps.
Figure 15.4 — Conclusions by component

Why

For each component choose whether it operates effectively, effectively except for severe (not pervasive) deficiencies, or not effectively (1), with a note (2). Engagement performance carries DF-00001.

Who

Quality lead.

What to do

  1. Choose the conclusion (1) and write a note (2) for each component.

Back to top ↑

15.5 The overall conclusion

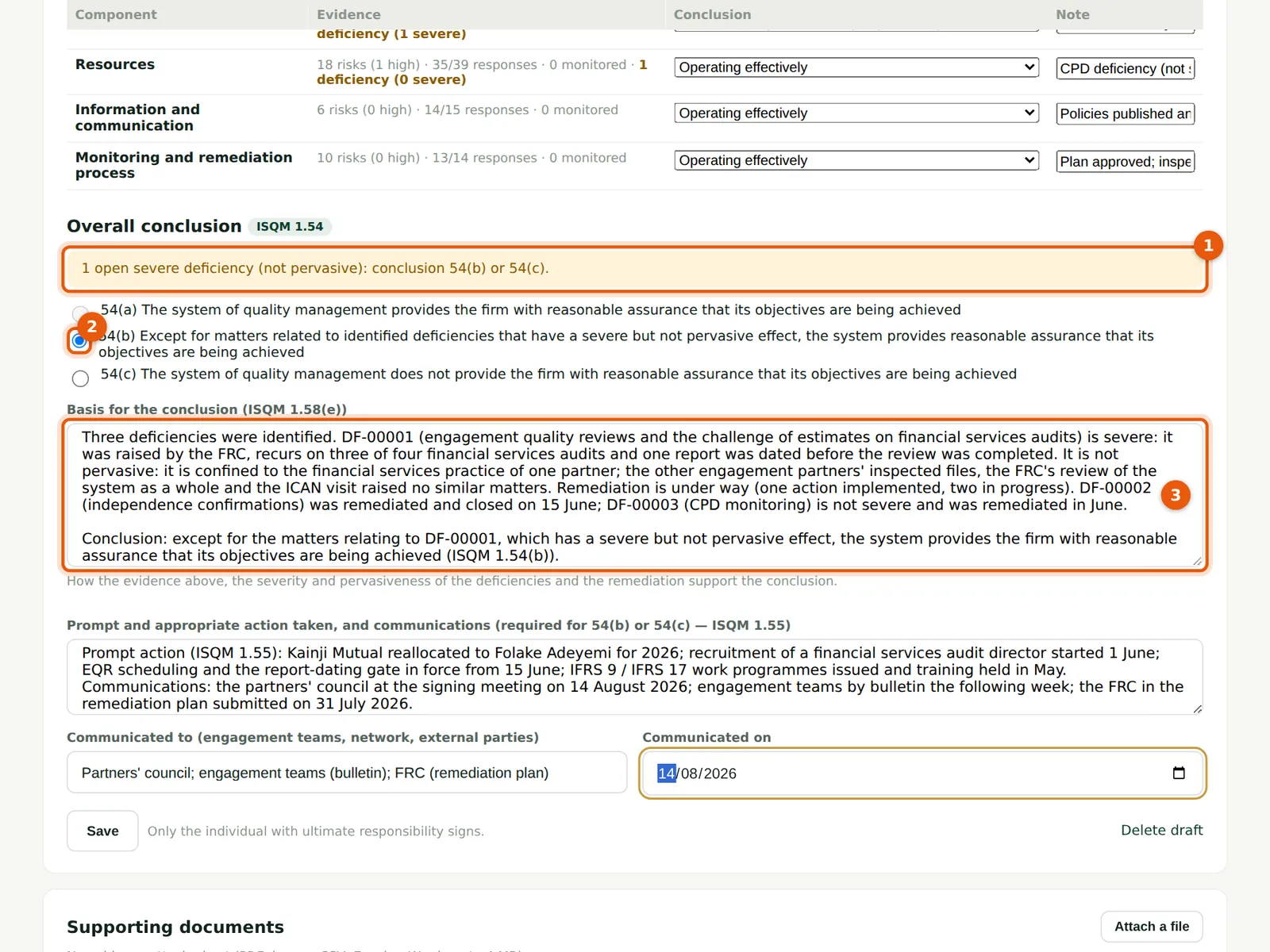

SQMTrove screenshot: Overall conclusion (ISQM 1.54). Numbered orange markers point to the items described in the steps.
Figure 15.5 — Overall conclusion (ISQM 1.54)

Why

The banner (1) shows which conclusions the open deficiencies allow: with one severe, not pervasive deficiency open, only 54(b) or 54(c). Choose the conclusion (2) and write the basis (3) — ISQM 1.58(e) requires it to be documented.

Who

Quality lead (drafts); the Owner decides.

What to do

  1. Read the banner (1); choose the conclusion (2); write the basis (3).

Back to top ↑

15.6 Actions and communications

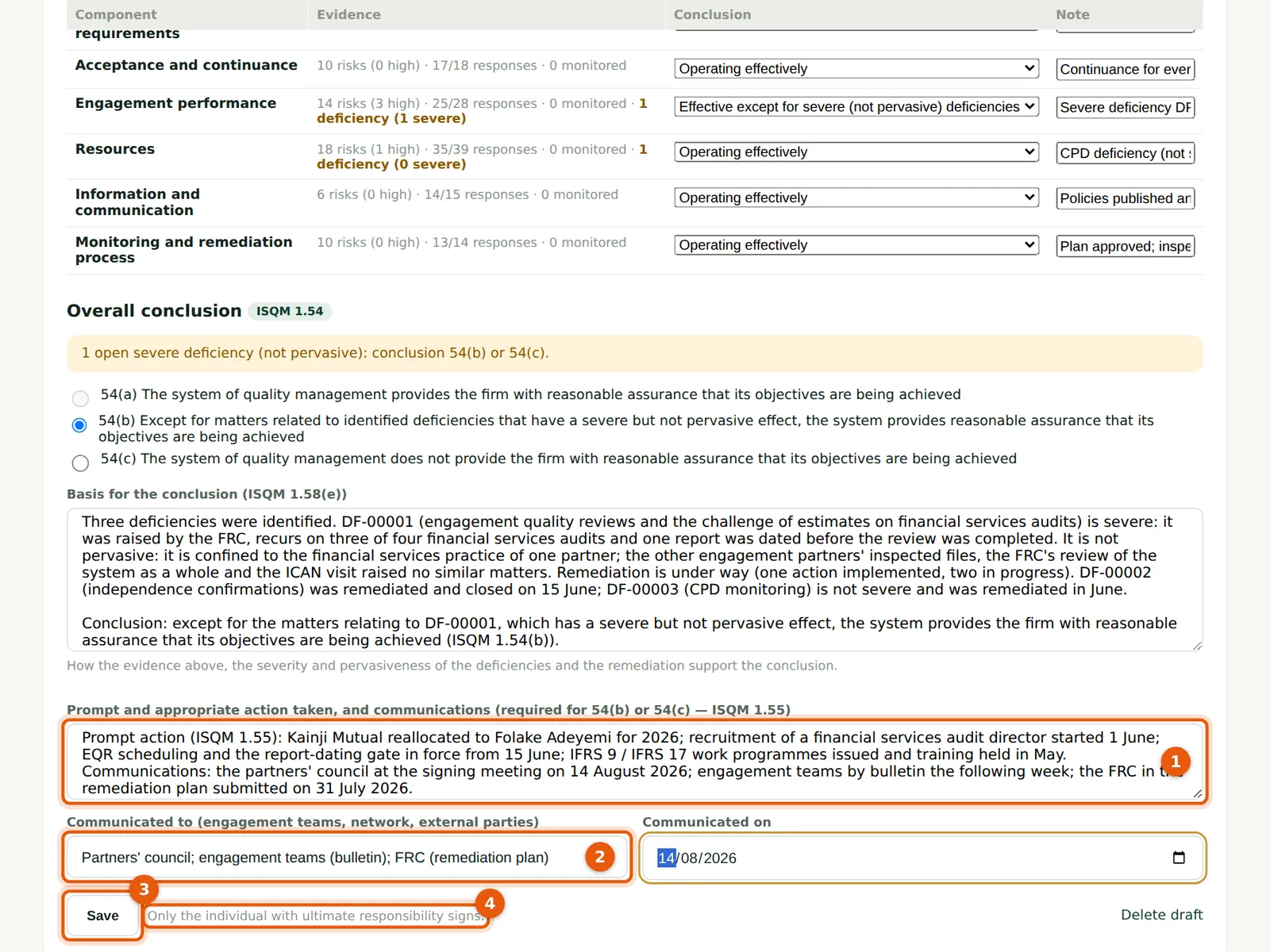

SQMTrove screenshot: Prompt action and communications (ISQM 1.55). Numbered orange markers point to the items described in the steps.
Figure 15.6 — Prompt action and communications (ISQM 1.55)

Why

For 54(b) or 54(c), record the prompt and appropriate action taken (1) and to whom the conclusion was communicated (2), and when. Save (3) keeps the draft; only the individual with ultimate responsibility can sign (4).

Who

Quality lead.

What to do

  1. Record the actions (1), the people communicated to (2) and the date; choose Save (3).

Back to top ↑

15.7 Sign the evaluation

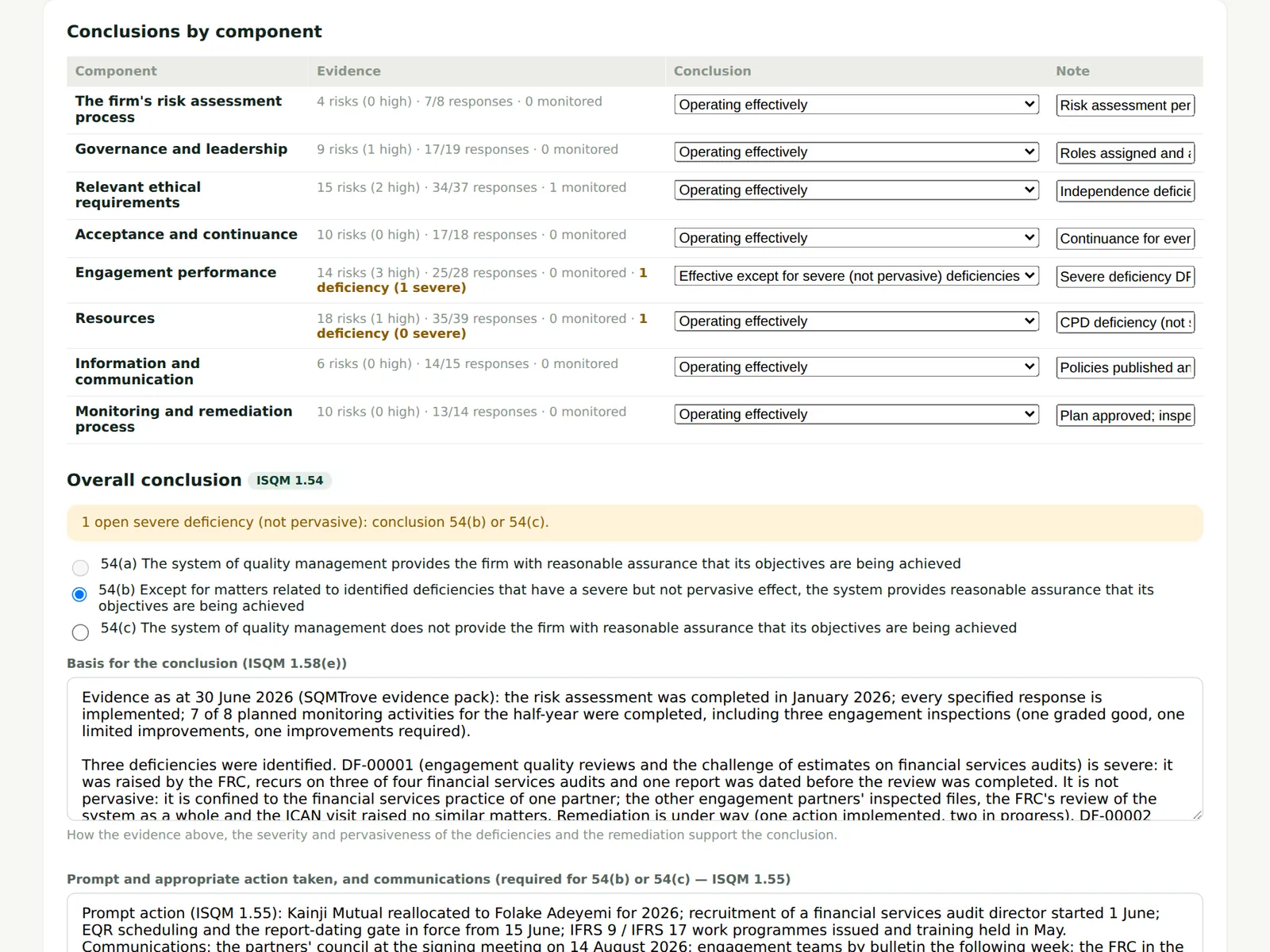

SQMTrove screenshot: Adaeze Nwosu signs, 14 August 2026. Numbered orange markers point to the items described in the steps.
Figure 15.7 — Adaeze Nwosu signs, 14 August 2026

Why

Only the person assigned ultimate responsibility in Governance & leadership sees Sign the evaluation (1).

Who

The individual with ultimate responsibility (the Owner).

What to do

  1. Read the evaluation and choose Sign the evaluation (1).

Back to top ↑

15.8 Confirm the signature

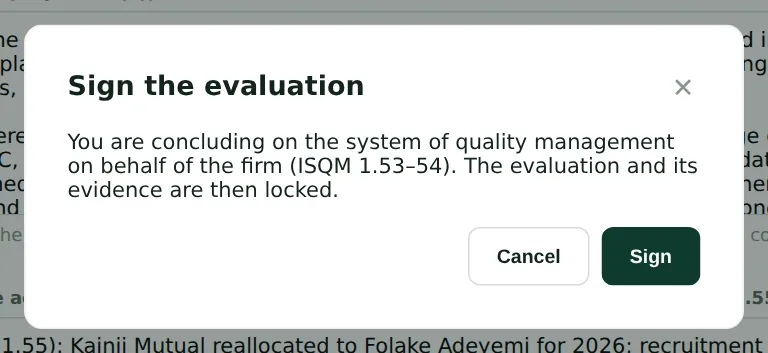

SQMTrove screenshot: Sign the evaluation. Numbered orange markers point to the items described in the steps.
Figure 15.8 — Sign the evaluation

Why

Signing concludes on the system on behalf of the firm. The evaluation and its evidence are then locked.

Who

The individual with ultimate responsibility.

What to do

  1. Choose Sign.

Back to top ↑

15.9 The signed evaluation

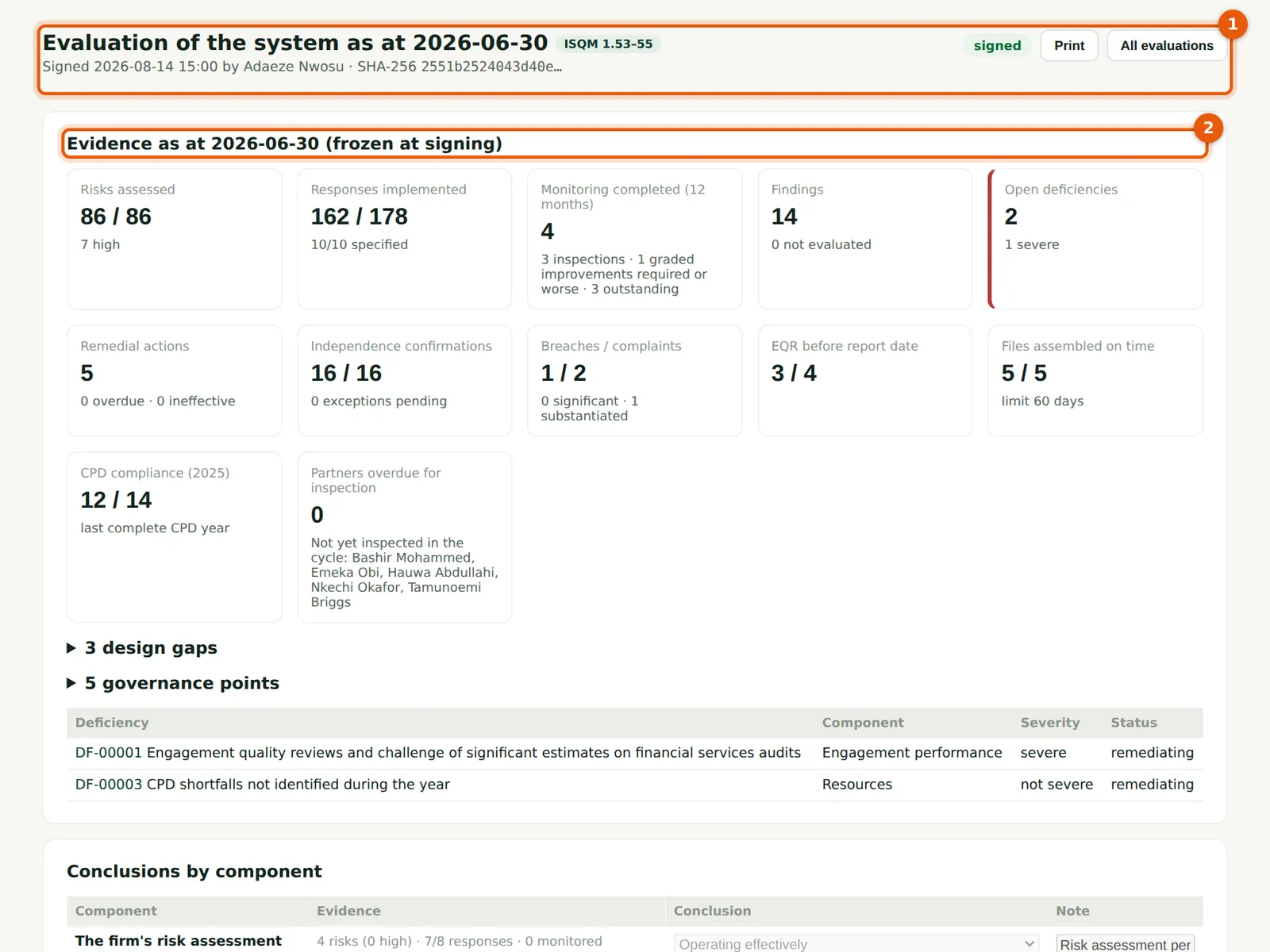

SQMTrove screenshot: Evaluation of the system as at 30 June 2026, signed. Numbered orange markers point to the items described in the steps.
Figure 15.9 — Evaluation of the system as at 30 June 2026, signed

Why

The heading (1) shows who signed and when, with a SHA-256 fingerprint of the record, so any later change would show. The evidence (2) is frozen as it was at signing.

Who

Everyone with access; inspectors.

What to do

  1. Choose Print for a paper or PDF copy.

Back to top ↑

15.10 The evaluations register

SQMTrove screenshot: Annual evaluation: the 2026 evaluation. Numbered orange markers point to the items described in the steps.
Figure 15.10 — Annual evaluation: the 2026 evaluation

Why

Each evaluation with its conclusion, status and signature (1). The dashboard shows the latest conclusion.

Who

Everyone with access.

What to do

  1. Choose a row to open the evaluation.

Back to top ↑
